Nearly 40% of planned weekly work on construction sites isn't delivered: New Buildots Intelligence Lab Global Benchmarks Report
Source: PR Newswire

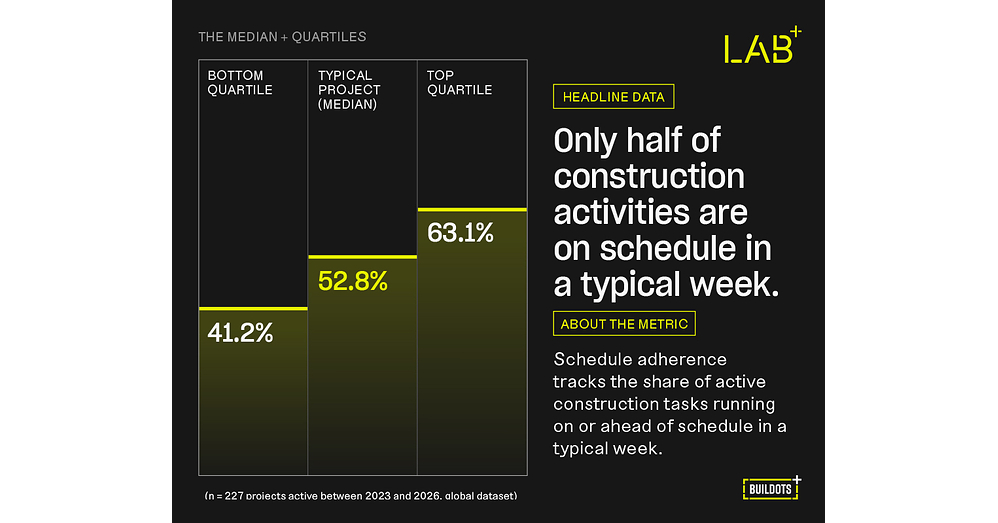

Buildots' Global Construction Benchmarks Report finds sites keep 52.8% of activities on schedule, while typical activities finish 5.3 weeks late and projects deliver 63% of planned weekly output. 70.7% of activities miss their planned start date, and 20 of 21 measured activities fall short of planned weekly output; top-quartile projects limit delays to 2.3 weeks. Buildots says the report establishes a global baseline, with sector-specific editions for data centers and healthcare planned next.
Analysis
The investable signal is not that construction productivity is suddenly improving; it is that owners and contractors may gain a common measurement layer. If benchmarks become embedded in bids and project controls, owners could eventually demand less schedule contingency and price work against demonstrated throughput. That shifts bargaining power toward owners and makes execution variance more visible—potentially pressuring contractors on fixed-price work before better measurement translates into lower costs. Conversely, contractors able to prove reliable delivery could win share or protect pricing.
The near-term read-through to HOCHTIEF (HOT) and Bouygues (EN) is limited: their inclusion as Buildots users does not establish deployment scale, realized savings, or material revenue exposure. Intel (INTC) is an owner/customer reference, not evidence of a change to its construction schedule or capacity outlook. Data-center and healthcare editions could make schedule benchmarking more relevant to large-project procurement, but the report does not show that software adoption causes faster completion.
Contrarian point: the benchmark may expose a large operational gap without creating a scalable solution. The source is Buildots, and aggregated data may be subject to selection and coverage biases; activity tracking is not the same as improved productivity. Over 1–3 months, watch for independent validation and customer disclosures tying adoption to schedule or cost outcomes. Over 6–18 months, broader use in contracts could reduce contingency and alter contractor-owner economics. A thesis that productivity tech is becoming financially material is falsified if deployments remain pilots or users do not report measurable project-level improvements.
AllMind Terminal
AI-powered research, real-time alerts, and portfolio analytics for institutional investors.
Request TrialMarket Sentiment
Overall Sentiment
mixed
Sentiment Score
-0.05
Key Decisions for Investors
- No event-driven position in INTC, HOT, or EN on this release alone; it provides no company-specific financial or deployment data.
- Watch Buildots’ sector editions and verify the underlying sample, project coverage, and methodology before treating the benchmarks as representative or using them to revise contractor assumptions.
- For HOT and EN, monitor earnings commentary for quantified schedule adherence, rework, claims, or margin effects—not general references to digital tools. Evidence of persistent fixed-price overruns would be a negative; independently verified delivery improvements would support a positive view.
- For data-center exposure including INTC, treat schedule/productivity measurement as a potential execution-risk mitigant, not a near-term capacity catalyst. Reassess only if project-level timelines or management guidance change.
More News
- OpenAI's revenue scare, Delta earnings, what investors think of a Starbucks-Chipotle deal and more in Morning Squawk
- Sequoia-backed Nuvacore seeks $2.5bn valuation in funding round
- Stock Movers: Intel, Schneider, Skyworks Solutions (Podcast)
- Decade-old RAM is making a comeback
- Intel is reportedly launching new CPUs on old sockets that support DDR4 memory
- This Forgotten AI Stock Is Up 689% and Nobody's Talking About It
From AllMind Research
- Anthropic IPO Preview: Valuation, Timing, and What to Watch
- Shein After the IPO: Venue, Valuation, and What Must Be Proved
- What AI Research Tools Should a Small Hedge Fund Buy First?
- How to Search Earnings Call Transcripts With AI
- What a Concept From Nature Tells Us About How C-Suite Executives Actually Think About AI
